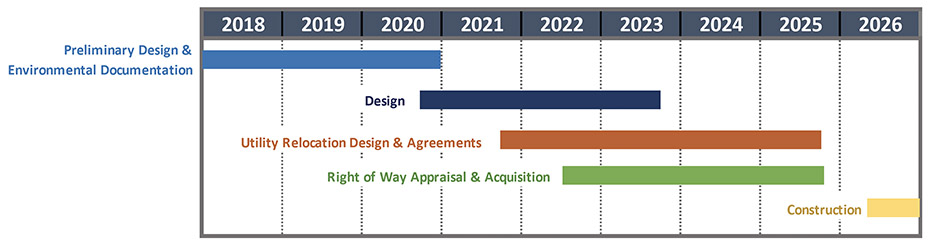

Project Schedule

graphic timeline of the project schedule
  • Preliminary Design & Environmental Documentation: 2018-2020
  • Design: Fall 2020 - Summer 2025
  • Utility Relocation Design and Agreements: Fall 2021 - Fall 2025
  • Right of Way Appraisal and Acquisition: Winter 2023 - Fall 2025
  • Construction Advertising: Late 2025, construction activities likely 2026

Why so long?

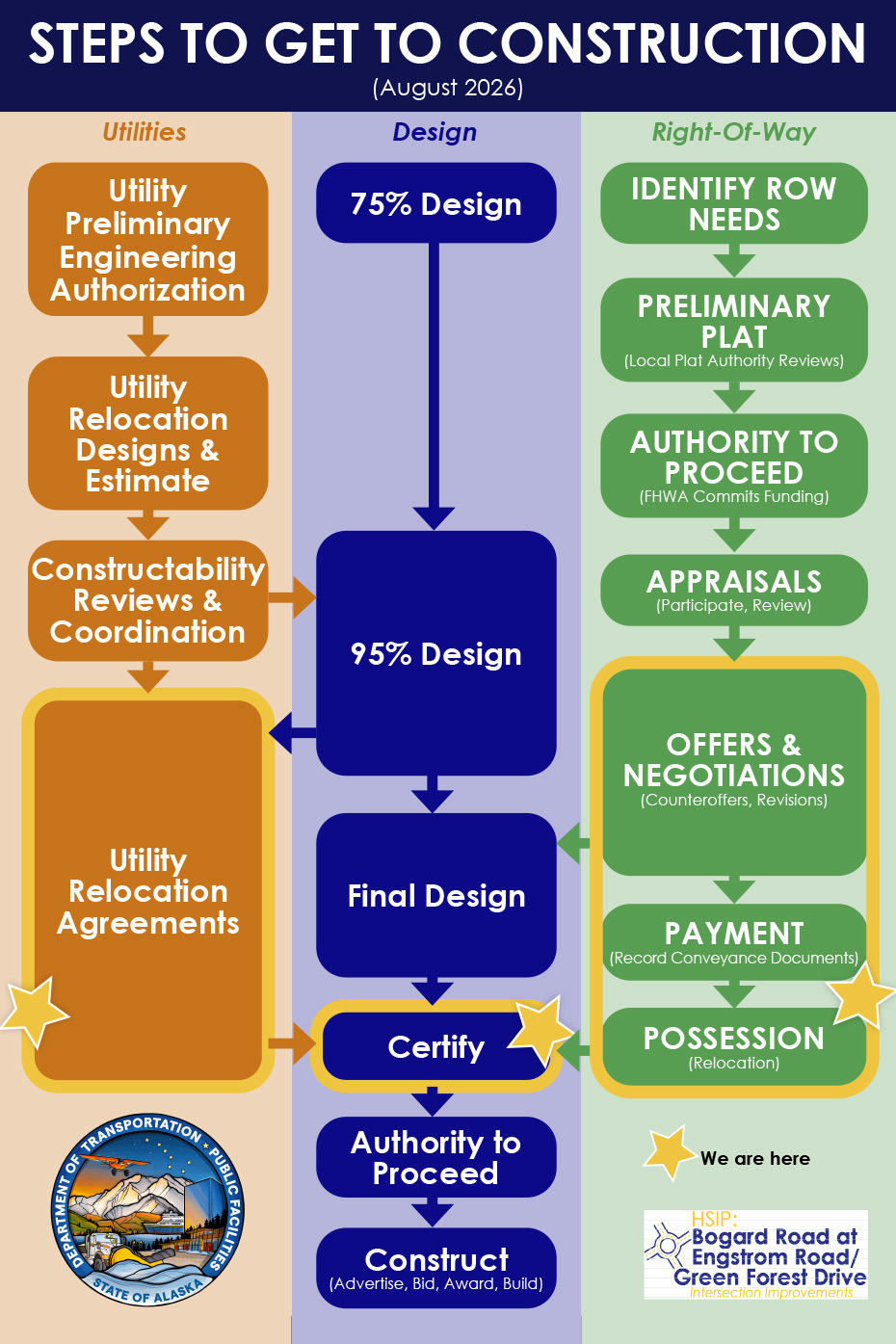

This figure shows the steps remaining after the 75% design was presented to the public at the October 13, 2022 Open House.

This figure shows the steps remaining after the 75% design was presented to the public at the October 13, 2022 Open House. The preliminary Right-of-Way acquisition plat was reviewed by the Mat-Su Platting Board and conditionally approved February 8, 2023. This project requires numerous utility relocations and purchases of private property. Coordination with individual utilities and property owners in compliance with Federal requirements will take time.

logo of the Alaska Project Exchange

Use DOT&PF's Alaska Project Exchange tools to learn more about all of DOT&PF's active construction projects statewide!

  • Want to know how construction will impact road traffic? Visit 511.alaska.gov
  • Want to dig into the details about projects across the state? Visit dot.alaska.gov/construction
