Skip to content
Federal/State Project No: CFHWY00130

Sterling Highway Milepost 82.5 to 94

Share Your Comments on the Design

The project team is offering one more way for you to share comments on the design. Click here to view the design and leave comments directly on the map.

Upcoming Public Involvement Opportunities

Thank you to everyone who was able to attend the recent open houses, Anchorage Transportation Fair, and Kenai Peninsula Home Show. Please check the Documents Page if you were unable to attend or would like to view the materials shared.

The project team will be sharing project information at these upcoming events:

No Events Scheduled - check back soon

There will be additional opportunities to meet with the project team as we get closer to construction, and of course, you can always reach us via email or by phone at (907) 562-2000, or add comments on the webmapper,. We will share updates as more public meeting opportunities are scheduled

Description

project logo

The Alaska Department of Transportation and Public Facilities (DOT&PF) is proposing to improve safety and reduce congestion for people and motorized vehicles traveling along the Sterling Highway between Sterling and Soldotna. This project will address known safety concerns - which led to Traffic Safety Corridor designation on this section of the Sterling Highway in 2009 - by providing travelers with a safe and reliable roadway that supports the efficient year-round movement of goods, services, and people while accommodating the seasonal increase of tourist and recreational traffic.

The proposed project will reconstruct the Sterling Highway from milepost 82.5 to 94. Current traffic and crash data will be analyzed to determine the number and configuration of travel and turn lanes and may consist of multiple options to best meet the various needs along the corridor. Additional improvements may also include:

  • Separated bike/pedestrian pathway along the north side of the highway
  • Turn lanes
  • Intersection realignments
  • Highway lighting

Note: The design will not change the existing five-lane highway configuration in Sterling or Soldotna.

Project Area Map

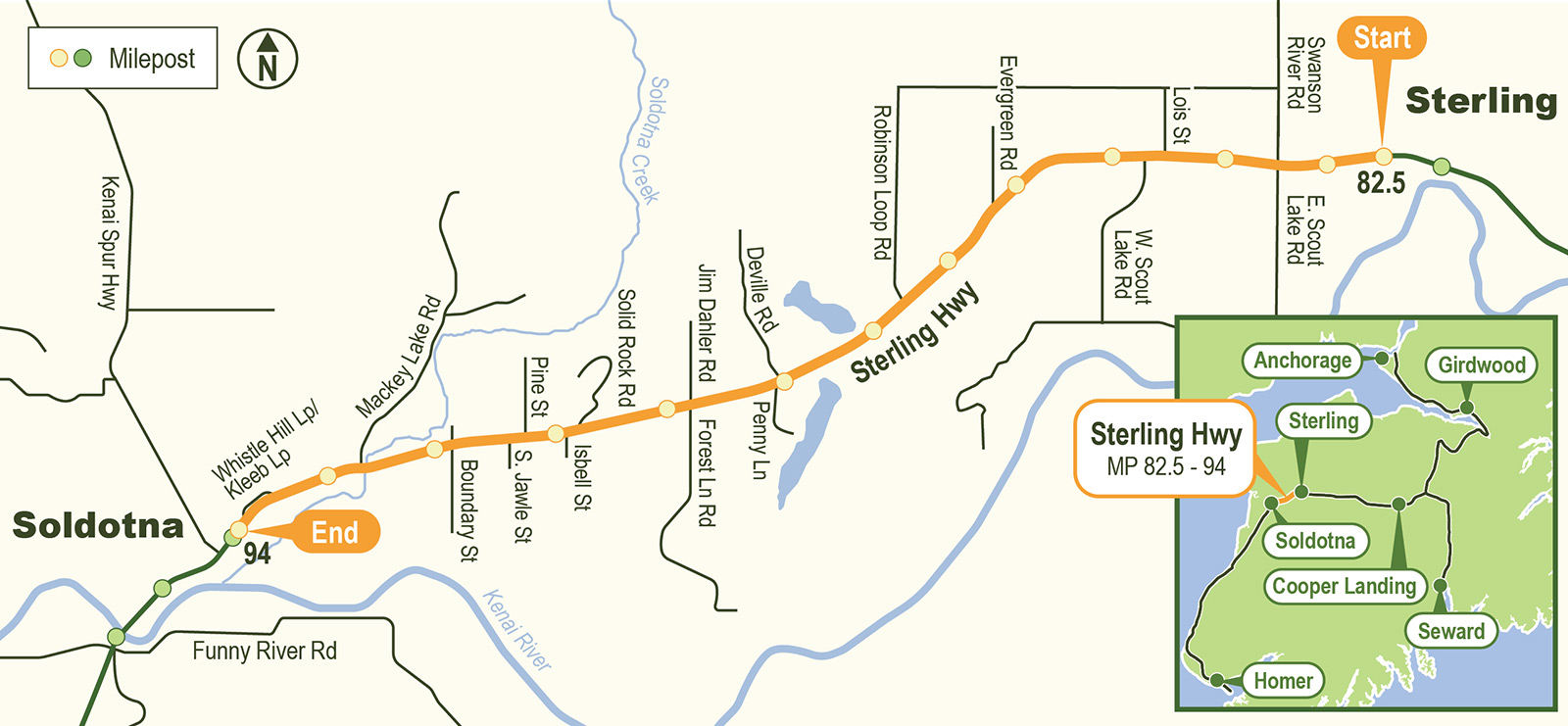

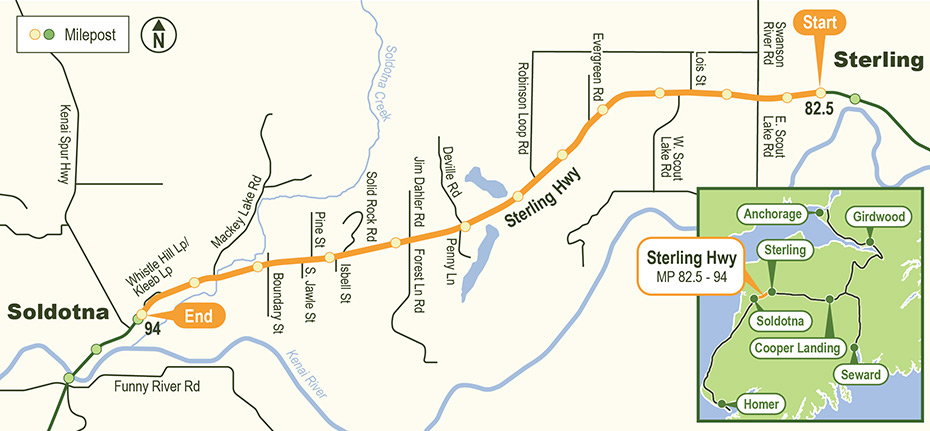

project area map

Schedule

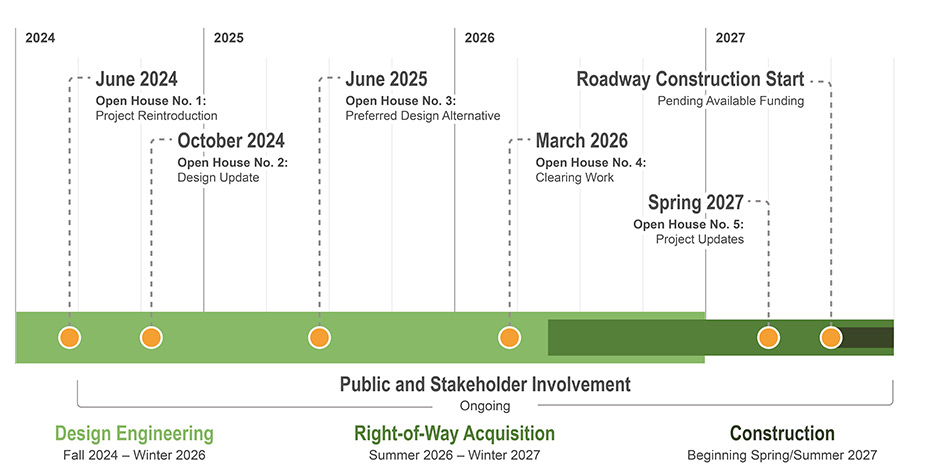

schedule shown in graphic table

Contact

Send your comments, questions, or concerns to the project team by emailing SterlingSafetyImprovements@dowl.com or by calling (907) 562-2000.

Julia Hanson, P.E.
DOT&PF Project Manager
(907) 269-0753

Jeff Schock, P.E.
QAP Construction Project Manager

Steve Noble, P.E.
DOWL Design Project Manager

Stephanie Queen, AICP
Public Involvement Lead

The Alaska DOT&PF operates without regard to race, color, national origin, sex, age, or disability regardless of the funding source, including Federal Transit Administration, Federal Aviation Administration, Federal Highway Administration, and state funds. Full Title VI Nondiscrimination Policy: dot.alaska.gov/tvi_statement.shtml. To file a complaint, go to: dot.alaska.gov/cvlrts/titlevi.shtml.

The DOT&PF complies with Title II of the Americans with Disabilities Act of 1990. Individuals with disabilities who may need auxiliary aids, services, and/or special modifications to participate in this public meeting should contact Public Involvement, (907) 562-2000, and TDD number [711]. Requests should be made at least five days before accommodation is needed.

The environmental review, consultation, and other actions required by applicable Federal environmental laws for this project are being, or have been, carried out by DOT&PF pursuant to 23 U.S.C. 327 and a Memorandum of Understanding dated April 13, 2023, and executed by FHWA and DOT&PF.
